You are not logged in.

Announcement

Announcement: This forum is accepting new registrations via email. Please see Recruiting Topic for additional information. Write newmarsmember[at_symbol]gmail.com.
  1. Index
  2. » Search
  3. » Posts by GW Johnson

#1 Re: Science, Technology, and Astronomy » Heat Shield Design Manufacture Application Maintenance » 2026-04-13 16:00:09

I think the closeup photo is an enhanced version with clearer focus,  but a reduced view dimension,  of the blurry photo that shows the whole capsule.

I an not at all sure this has anything to do with being "hoisted up".  I suspect without proof the blurry photo was taken just before splashdown,  still hanging from the main chutes.

Take a good look at the clearer restricted-view photo.  This was intended to show the damage near one attachment pad that did not survive.  That is what the whitish "stain" is,  staining from the melting metal.  There is extra erosion there,  too.

But,  look up at the lateral side near that same place.  Do you,  or do you not,  see exposed and distorted metal,  and maybe a burn-through,  where the lateral-side heat tiles were thinner?  Maybe too thin? Those whitish areas are not windows,  they are exposed locations of the metal outer shell to which the heat shield tiles were attached.

GW

#2 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-04-13 15:51:02

Another follow-up to post 89.  I finally found enough photos to make a preliminary assessment of the Artemis-2 heat shield.

Both NASA and I were right,  in the sense that NASA said that a single heating pulse no-skip re-entry would reduce cratering damage (it did).   I said that cratering would still occur,  albeit reduced and smaller,  without the reinforcing hex (and it did).

I did see something else nobody expected:  complete localized heat shield loss and metal distortion or burn-through,  on the more windward lateral side of the capsule,  while flying at angle of attack to generate a side force for fine trajectory control (something done since Gemini).

It would appear that flow along that side,  supposed to be a separated wake zone,  was instead at least intermittently attached,  with resulting far-higher convective heating than the thinner Avcoat tiles there,  could resist.  This was the side opposite the windows.  That windows side looked to be in good shape.

GW

#3 Re: Human missions » Artemis Coverage of Manned Mission(s) » 2026-04-13 15:32:09

I put an Artemis-2 mission article up over at my "exrocketman" site,  titled "About the Artemis-2 Mission",  posted 31 March 2026,  search code 31032026.  Today (13 April) I added an update with photos,  that lead to a preliminary assessment about that heat shield.

Both NASA and I were right.

NASA was right that eliminating the two-heating-pulse skip entry would reduce heat shield damage.  It did.  I was right in saying that at least some chunk-shedding crater damage would still occur,  and it apparently did.  The photos I found so far prove that.

Unexpectedly,  I also saw heat shield damage to the lateral wall of the capsule,  on the side closer to the stagnation point,  away from the windows.  That is where the Avcoat bonded tiles were thinner.  Hex in those tiles would greatly reduce that,  but maybe a bit thicker is also needed,  too.  The damaged metal was the outer skin to which the tiles are bonded.  That is NOT the inner cabin pressure shell!

What that means is that if NASA would put the hex into the bonded tiles,  less damage would occur,  even with a two-heating-pulse skip entry.  I have already told them how to do that,  without resorting to manual hand-gunning of the Avcoat in the hex cells.  They need to do that before flying again to the moon,  with a 10.9 km/s entry.  Artemis-3 will come back at only 7.9 km/s from LEO.  Even what they have now will be adequate for that.

GW

#4 Re: Human missions » Starship is Go... » 2026-04-13 15:05:23

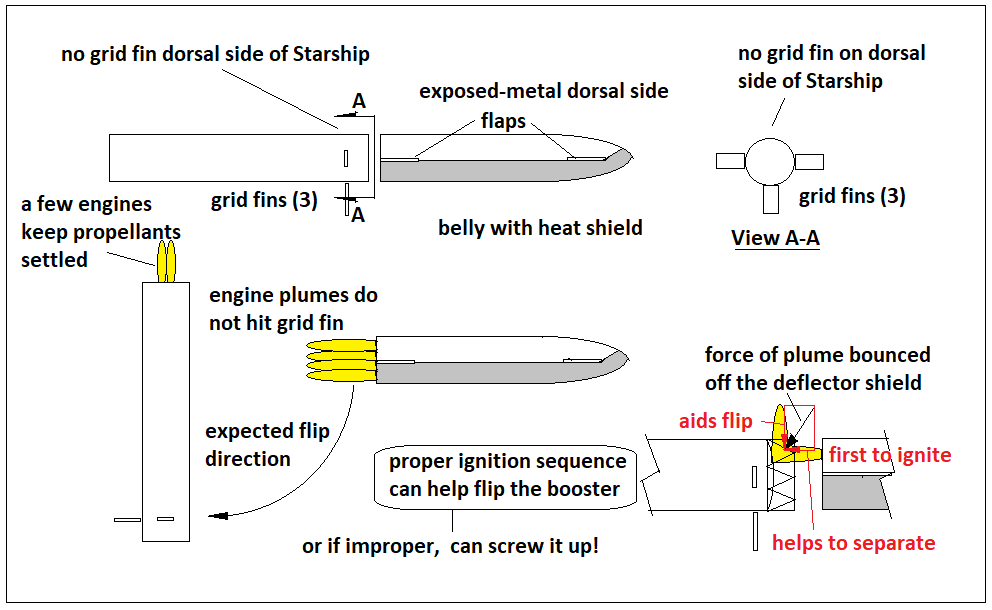

Both SpaceX and Blue Origin are companies that first and foremost have to make a profit,  not lose money.  SpaceX was profitable with Falcon-9/-Heavy,  but has bet its future "farm" on rideshares with Starship/Superheavy.  They still have their hands full just trying to make Starship/Superheavy work at all as a transport to LEO.  Blue Origin has its hands full trying to make New Glenn into a profit center.  Coming up with a contracted NASA lunar lander is a smaller piece of that overall larger puzzle,  for both of them.  I cannot fault their priorities.

Of the two,  I suspect Blue Origin might be a little closer to satisfying the NASA lander contract.  That is because SpaceX bit off a much-larger piece of "iffy" technology advancement,  trying to do the all-reusable Starship/Superheavy.  Plus,  my reading of the events suggests the ratio of Musk time to real time (3 to 4) is a bit bigger than Bezos's ratio (2 to 3).

The time from lunar rendezvous being the adopted Apollo architecture in 1964 or 1965,  to the Apollo-9 checkout of the Apollo CSM with its LM in LEO in 1969,  was only 4 or 5 years!  THAT is how long it took Grumman to come up with a workable lander,  under a crash program where cost was no object.  And higher risk-taking by NASA with its astronauts was "normal".

Artemis is NOT a crash program where cost is no object,  and NASA (I hope) has learned not to take such extreme risks with its astronauts!  Expecting SpaceX and Blue Origin to come up with anything workable as a lunar lander in only 4 years or so,  is actually quite unreasonable!  SpaceX started only 2-3 years ago,  and Blue Origin "in earnest" only last year.

You CANNOT count the proposal and contract-win time,  as real hardware development time!  That only sets the concept they will focus upon.  REAL development only starts AFTER contract award.  And coming up with a concept has NOTHING to do with its development into something real!  That's just life.  Ugly,  ain't it?

NASA projecting schedules that have no reality tells me there is no one there anymore that understands the difference between company time and real time,  and that the ratio varies from company to company.  I would expect that,  after all the former traditional contractors agglomerated into monopolies that no longer really compete (with the government making no anti-trust moves to stop it).  THAT is why "new space" has had such a hard time getting established.  The game was rigged.

GW

#5 Re: Science, Technology, and Astronomy » Heat Shield Design Manufacture Application Maintenance » 2026-04-12 15:18:44

With Spacenut's photo of the fiberglass hex with the hand-gun tool inserted,  I an now sure that the hex's resin was phenolic.  I saw a lot of electrical and electronic board materials in the 60's and 70's made of this very same stuff.  The color is the key to identifying it:  that orange is commercial phenolic resin,  on plain white fiberglass cloth.  Cures at modest heat and only some pressure between mold platens,  if you are making flat panels.  I do not know what tooling was used to make hex.

The type of phenolic that went into the glass and silica phenolic materials was different!  It cures under greater heat and a lot of pressure,  and is tan in color.  I used a lot of silica phenolic in ramjet nozzles,  and in rocket nozzle assemblies.  It is tough,  dense,  slow-ablating,  and very heavy.  The fiber is in woven cloth form,  and you must be very careful to orient the cloth layers correctly relative to the flow direction.

GW

#6 Re: Science, Technology, and Astronomy » Heat Shield Design Manufacture Application Maintenance » 2026-04-12 09:10:09

Avcoat is a thick,  not-quite-liquid,  paste that is more like a dry mortar or cement material,  comprised of epoxy-novolac polymer heavily loaded with silica fiber and phenolic microballoons.  The polymer contribute the carbon to the char layer,  with the silica fibers contributing some silica content.  But the char is largely porous amorphous carbon.  I do not know the standard percentages of the components,  but I do know they can vary,  especially the microballoon content. Porous amorphous carbon char handles to the touch about like a piece of charcoal from the BBQ grill that is burnt-through but not yet consumed to ash.

The microballoons contribute the porosity required to get the pyrolysis gases out from the pyrolyzing layer through the char.  That is a serious issue in inch-plus thicknesses,  not very much in fractional-inch thicknesses.  And that is because the lower the permeability letting the gas out,  the higher the driving gas pressure must be,  to get out.  And carbonaceous char is a very structurally weak material,  especially in tensional loadings.

The microballoons lower the density,  to around sp.gr = 0.51,  instead of slightly greater than 1.  That also increases the ablation rate (which is both pyrolysis and erosion of the char from the surface as fine grit).  Higher microballoon content is lower density,  higher ablation rate,  and higher char permeability. It's a tradeoff,  and can be varied from place to place on the heat shield,  if desired.

The heat shield on Apollo and on Orion EFT-1 was hand-gunned with what amounts to an air-powered caulking gun into each and every cell of a fiberglass hex bonded to the capsule structure.  I think it was probably fiberglass-phenolic,  but I do not know for sure that it was phenolic.  I am sure of the fiberglass.  These cells are on the order of at most hlf an inch in dimension.  There were almost 300,000 of them on Apollo,  and nearly 400,000 of them on Orion,  in part because the lateral sides also needed the protection.  That glass fiber hex reinforcement provides tensile strength to retain char from breaking off,  and acts to limit cracks propagating from cell to cell.

The enormous time and cost of the hand-gunning is why they decided to cast Avcoat blocks and machine precision tils from them.  These were bonded to the capsule structure the way that PICA or PICA-X tiles would be bonded.  The bonds and gap-fillers worked fine on Artemis-1,  but the retention of the char did not.  Without the reinforcing hex to hold it down and limit crack spread,  several large chunks and bunch of small ones spalled off during that entry.  Complicating that was this was a skip entry,  with 2 heating pulses separated by a modest cooldown.  A lot of these materials,  particularly silica,  suffer a solid phasa change at about 2300 F that causes shrinkage by around 3%,  and embrittlement to the point of no strength at all:  they just crumble at a touch.

That hex-reinforced Avcoat worked just fine on every Apollo and that Orion EFT-1. Something similar flew on Gemini with the hex cell thing on only the heat shield (the lateral sides were bare superalloy),  but the polymer was a Dow Corning silicone,  and I do not know what solids it was loaded with.

The problem was that Artemis-2's heat shield was built and shipped for assembly before Artemis-1 ever flew.  The spalling of chunks caught everyone by surprise.  Their thermo-structural models and arc jet data did not predict this.  So was it the lack of hex,  or the two-heating pulse skip?  NASA spent a year convincing its management that it was the skip,  so they flew Artemis-2 back with almost no skip at all.

Myself,  I think it's actually both effects.  They need to put the hex into the tiles,  but they need to do it without hand-gunning,  or they might as well go back to the Apollo and Orion EFT-1 technique.  I figured out a way to load all the cells at once in a chunk of hex,  using an extrusion press,  in order to make hex reinforced blocks for machining the bonded tiles.  And I gave that to NASA,  although so far they have ignored me.

I have seen one blurry photo of Artemis-2 being hoisted out of the sea.  Everybody comments on the weird-looking but expected damage near one of the four hold-down pads.  I thought I saw some missing-chunk craters,  fewer and smaller than Artemis-1,  but there!   But,  the photo was blurry,  so I as-yet know nothing for-sure!  I did see some localized outer-layer burn-through damages on the lateral side,  low down,  close to the heat shield,  in some of the photos of the crew standing next to it.  The Avcoat is very thin there.

GW

#7 Re: Human missions » Starship is Go... » 2026-04-11 15:11:17

There are 2 "credible" lunar lander candidates,  the SpaceX HLS,  which is still nothing but a paper design,  and the Blue Origin "Blue Moon" landers,  the smaller uncrewed version being under construction.  I do not know if the larger crewed form has seen any construction yet.

How those undeveloped statuses blend with some sort of Artemis-3 mission in LEO in 2027,  is beyond me to understand!  That mission is publicly said to be about docking with,  and maneuvering with,  one or the other or both landers,  as prep for a landing mission (or two landing missions) in 2028.

Sounds like BS to me.  I must conclude that there is no one left alive at NASA today,  who is competent to distinguish between Musk time and real time,  or Bezos time and real time.

GW

#8 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-04-11 15:02:11

A follow-up to post 88.

I saw a NASA news conference where they indicated that the recovery divers took underwater photos of the Artemis-2 heat shield while the astronauts were being extracted.  None of these were shown at the news conference,  and I cannot find them on-line.

You would think that if these showed no char chunk-shedding cratering,  they would have been posted quickly,  to quiet critics like me,  former astronaut Camarda,  and many others.  But THAT has NOT happened!

I have to wonder what those photos really show!

GW

#9 Re: Unmanned probes » Artemis I unmanned Flight Coverage » 2026-04-11 14:57:28

Forgive me,  but why is the Artemis-2 stuff listed under "unmanned probes"?  There were 4 people aboard!

GW

#10 Re: Unmanned probes » Artemis I unmanned Flight Coverage » 2026-04-11 09:52:02

The Navy does not operate Sikorsky Skycranes.  The Army did fly a few,  but most of them serve commercially now.

GW

#11 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-04-11 09:48:52

Well,  Artemis-2 made it back with 4 astronauts safe and sound.  I am very glad about that.  I have seen no images of the condition of their heat shield yet.  Sure would like to see one!  I am expecting to see chunk-shedding cratering,  similar to Artemis-1,  maybe reduced,  maybe not.

Meanwhile projecting an Artemis-3 flight to dock with a lunar lander in LEO in 2027 is nonsense,  until there really is a lunar lander to dock with.  So is projecting lunar landings in 2028.  Not until there is a lunar lander!

GW

#12 Re: Human missions » Starship is Go... » 2026-04-09 10:27:30

I see that SpaceX has pushed the next Starship/Superheavy launch off into May.  No reason has been given that I know of.  But I suspect this one is different enough from the block 2 version that flew previously,  that it is taking them longer to make sure they think it is ready to fly.  THAT is why Musk time and real time differ by about a factor of 3.

GW

#13 Re: Meta New Mars » GW Johnson Postings and @Exrocketman1 YouTube videos » 2026-04-09 10:24:32

Today's "Daily Launch" from AIAA finally brings up the heat shield issue facing Artemis-2 as it heads to re-entry.  The link was to a Scientific American article of some kind.  Not all the supposed facts quoted in it were correct,  but the concern over char cracking leading to the shedding of chunks of char was correctly pointed out.

Myself,  I think the odds are good that the crew will come home just fine.  Where I differ with NASA is that I think the same damage seen on Artemis-1 will happen to Artemis-2's heat shield,  despite switching to a non-skip,  single heating pulse entry.  It might be less than what happened to Artemis-1,  or it might not.  But if ANY chunks at all get shed,  then NASA was wrong and I was right!

GW

#14 Re: Science, Technology, and Astronomy » Simple approach to air conditioners? » 2026-03-17 12:25:54

The lowered static temperatures obtained in the supersonic expansion of a De Laval nozzle are intimately associated with the supersonic speed.  As soon as the stream slows down by any means whatsoever,  it rewarms.  If dead still,  it is at its stagnation temperature.  Unlike pressure,  you ALWAYS recover the full stagnation temperature,  no matter what.  Ttot = Tstatic * (1 + const * Mach^2) where constant = (gamma - 1)/2,  and for air,  gamma = 1.4 is usually a very good model.

I ran into that many years ago with ingested cooling air for the electronics in a towed decoy.  Once we started looking at supersonic speeds,  the cooling air started getting hot.  You may capture it at high speed relative to the decoy,  but you must slow it down very slow relative to the decoy in order to use it for anything at all.

The missile seeker guys also ran into this decades ago,  missiles being mostly supersonic,  even by the early 1950's.

GW

#15 Re: Human missions » Starship is Go... » 2026-03-13 12:47:01

They probably have enough on their plate trying to get Starship working acceptably well at all,  plus they have a contract that is all-but-in-default for an expendable version that is to be a lunar lander.  It's too early in the flight tests to be criticizing their decisions about what to spend their money and their efforts upon.

None of the projected numbers (masses,  dollars,  anything) are "real" until those tests are successfully completed,  and they are actually still somewhat bogus,  until actual operational experiences have been obtained.  That's just real life!

My guess is that they will have at least another test loss or two,  before Block 3 Starship and Block 3 Superheavy are actually flying into orbit and fully-recovering.  That's what you get when you operate with youngsters under age 40 and no "old hands" to impart the engineering art.

The art is the undocumented knowledge passed-on,  on-the-job,  one-on-one,  from old hand to newbie.  It is about 50% of the essential knowledge in production work,  and much more than that,  in development work,  which this Starship stuff is.  Art is the stuff not documented in project reports,  because nobody wanted to pay for all that writing.  SpaceX's youngsters have to learn that art the hard way,  by failing a lot,  in tests.  Their track record is not hard to understand,  at all.  It was the same with the Falcon series,  starting with almost going bankrupt before they got Falcon-1 to fly.

GW

#16 Re: Human missions » Spacesuits - personal spaceship » 2026-03-13 12:22:05

Too bad nobody is looking at MCP anymore.  They are choosing habitat and suit pressures too high for it.  Some are approaching 8 psia in the oxygen suit!  Such are not necessary.

Paul Webb's MCP test prototypes in the 1960's amounted to vacuum-protective underwear with an oxygen helmet plus a small backpack that had only oxygen plus a CO2 absorber in it.  No need for cooling equipment,  you just sweat right through the garment into vacuum.  Cooling by evaporation guaranteed!  The whole shebang weighed 85 pounds.,  although you would need protective outerwear over it,  for the thermal and mechanical hazards,  maybe another 5 lb.  10 lb at the very most.

His final prototype was very limber,  even more than the SpaceX suit.  It operated near the old Apollo suit pressure of 3.2-3.5 psi (170-190 mmHg in his reports),  although that gas pressure is only in the helmet and tidal breathing bag!  The clothing is unpressurized by gas at all,  just a tight fit exerting mechanical pressure upon the body.  The old partial pressure suits worked the same way,  but they did not apply pressure as evenly,  and they did not pressurize hands and feet at all.  Webb did.

I've seen the film of the test subject wearing Webb's MCP rig,  pedaling a bicycle ergonometer inside at vacuum tank at a simulated 87,000 feet,  which is more than 4 miles above the vacuum death point!  He was in there for 30 minutes and had no problems,  unlike the old partial pressure suits,  which were limited to 10 minutes max before fluid edema into uncompressed zones started hands and feet swelling.

Think about it:  vacuum protective underwear,  over which you wear whatever mechanical/thermal protective outer you need for the job at hand.  Easily launderable,  too!

And if you run your two-gas habitat atmosphere as 43% (by volume) oxygen (the rest nitrogen),  at 43% of a standard atmosphere,  the fire danger oxygen concentration driving chemistry rates is the same as sea level pressure air at 70 F,  the oxygen partial pressure is equal to air somewhere below 8000 feet (2500 meter) for no risks of chronic altitude sickness and no risks to childbirth,  and the nitrogen pressure is low enough compared to oxygen suit pressure that you need zero pre-breathe time,  all the way down to suit pressures of only 3.0 psia (155 mm Hg)!

Below 3.0 psia suit pressure,  there are tissue dry-out and bleeding problems in the airway and lungs,  although cognition can be maintained down to about 2.0-2.5 psia (100-130 mm Hg).  You just don't want more than a few minutes' exposure,  that low!  I have a similar,  not-as-easily-remembered,  habitat atmosphere that will do no pre-breathe down to 2.9 psia (150 mm Hg) suit pressure,  and yet still meet the life support and fire danger criteria.

MCP suits at 180 plus or minus 10 mm Hg,  and "rule-of-43" habitat pressure.  Easily-launderable space suits.  Lightweight backpacks.  No heavy cooling systems.  Very flexible allowing almost any human activity.  And it worked fine in ground tests,  more than 6 decades ago.  Looks like a match made in heaven to me!

GW

#17 Re: Interplanetary transportation » Forty 40 Ton Mars Delivery Mechanism » 2026-03-11 17:58:07

Spacenut:  what I am looking at is only nominally two 8 ft x 8 ft x 40 ft containers.  These could be rescaled a little bit.

GW

#18 Re: Interplanetary transportation » Forty 40 Ton Mars Delivery Mechanism » 2026-03-10 12:17:00

I'm not using a standard shipping container,  they are too heavy,  designed for ship-handling loads a space delivery item will never see.  I'm looking at something the size of a standard shipping container,  which is 8 ft x 8 ft x 40 ft.

GW

#19 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-03-10 12:13:36

My letter to Isaacman should be in a staffer's hands by about today.  The handout I sent him is already posted over at "exrocketman".

GW

update 3-13-2026:  the handout on ramjet ablatives overlapping with heat shields is titled "Ramjet Data Re: Heat Shields",  posted 1 March 2026 at http://exrocketman.blogspot.com.  Search code 01032026.

#20 Re: Meta New Mars » GW Johnson Postings and @Exrocketman1 YouTube videos » 2026-03-10 12:11:28

From the AIAA "Daily Launch" email newsletter for 3-10-2026:


Space
Incoming! 1,300-pound NASA satellite will crash to Earth on March 10

NASA's Van Allen Probe A will crash to Earth on Tuesday (March 10) after nearly 14 years in orbit, according to the Space Force's current best estimate.

-----

The window USAF projects is + or - 24 hrs from about 7 PM (not sure if eastern or central or what).

GW

Update 3-11-2026:  It came down this morning early,  reportedly over the "Eastern Pacific region",  which does not pin it down very well.  There is a second up there,  not expected to enter until the 2030's,  although that was the original expectation on this one.  The pair was operated until out of attitude control/maneuvering fuel,  with no way to safely dispose of them.  THAT has to change!

Update 3-12-2026:  today's "Daily Launch had this AP News headline summary:

AP News
Old NASA science satellite plunges back to Earth
An old NASA science satellite plunged uncontrolled from orbit and reentered over the Pacific on Wednesday. The U.S. Space Force said the Van Allen Probe A came in west of the Galapagos Islands.

GW

#21 Re: Human missions » Starship is Go... » 2026-03-10 12:06:40

From the AIAA "Daily Launch" email newsletter for 3-10-2026:

SpaceNews
First Starship V3 launch slips

SpaceX is pushing back the first launch of the latest version of its Starship vehicle even as NASA is asking the company to accelerate work on a lunar lander version of the vehicle. In a social media post early March 7, Elon Musk, founder and chief executive of SpaceX, announced that the first flight of version 3, or V3, of Starship would be “in about 4 weeks.” Four weeks from March 7 is April 4.

-----

GW

#22 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-03-09 09:13:14

From AIAA “Daily Launch” email newsletter 3-9-2026,  just the summary of an ARS Technica article:

ARS TECHNICA
With Gateway likely gone, where will lunar landers rendezvous with Orion?

Last week, NASA Administrator Jared Isaacman unveiled a major shakeup in the Artemis Program. The changes focused largely on increasing the launch cadence of NASA’s large SLS rocket and putting a greater emphasis on lunar surface activities. Days later, the US Senate indicated that it broadly supported these plans. Which lander will be used to take astronauts down to the lunar surface from an orbit around the Moon and back up to rendezvous with Orion?

-----
My take:

The rumors have proved to be true.  Gateway is essentially out,  SLS Block 1B and Block 2 are out,  and there will only be a slight upgrade to SLS Block 1 with the Centaur-5 replacing the Interim Upper Stage (the second stage of Delta-4).  Artemis will rendezvous with landers and do its landings from some lunar orbit that the SLS Block-1 can reach with Orion atop it.  That is likely some elliptic capture orbit,  but nobody is talking about that yet.  We will see whose lander “gets there” first.  That will be the one they use.

Isaacman is trying to do it “right”.  We will see if he can change the NASA culture back to crew lives valued more than schedule and money.  He has made noises like that,  but as yet I have seen no change at NASA.  Artemis-2 will fly with the same flawed heat shield that surprised everyone on Artemis-1.  Artemis-3 is already being built to the same flawed design.  Sooner or later,  the odds will bite them with that,  just like they did with the flawed SRB O-ring joint design with the space shuttle.

GW

#23 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-03-09 09:10:19

From AIAA “Daily Launch” email newsletter 3-9-2026,  following the link to a Spaceflight Now.com article:

NASA contract confirms selection of ULA’s Centaur 5 as new upper stage for the SLS rocket
March 7, 2026 Will Robinson-Smith


NASA officially selected United Launch Alliance’s Centaur 5 as the upper stage for its Space Launch System rocket starting with the Artemis 4 mission, scheduled to launch no earlier than early 2028.

The Centaur 5 was developed as the upper stage of ULA’s Vulcan rocket. The launch vehicle flew four times since its debut in January 2024 and the upper stage performed well across all flights.

The news, disclosed in contract documents published on Friday, comes one week after NASA Administrator Jared Isaacman announced that the agency would move towards a “standardization of the [Space Launch System rocket] fleet to… a near-Block 1 configuration.”

“The idea is we want to reduce complexity to the greatest extent possible,” Isaacman said during a briefing at the Kennedy Space Center on Feb. 27. “We want to accelerate manufacturing, pull in the hardware, and increase launch rate, which obviously has a direct safety consideration to it as well.”

Originally, NASA planned to launch the first three missions for the Artemis program using ULA’s Interim Cryogenic Propulsion Stage (ICPS), a modified version of its Delta 4 Cryogenic Second Stage, and then transition to the Exploration Upper Stage (EUS), built by Boeing, beginning with the Artemis 4 mission.

NASA, under Isaacman’s leadership, decided to move away from those plans due to cost and schedule overruns.

Long before this decision, Tory Bruno, ULA’s President and CEO at the time, was asked during a reporter roundtable in December 2024 about how the company would handle a theoretical change in the architecture for the SLS rocket. The question came up a month after President Donald Trump was elected to a second term, which sparked discussions of whether or not the SLS plans at the time might change.

“The Exploration Upper Stage is a very, very large upper stage. It’s much larger than the Interim Cryogenic Upper Stage that we’re providing now. It’s larger than a Centaur 5,” Bruno said. “If the government wants to change something in the architecture of SLS, they would tell us and we would tell them what we could do.”

That ‘what if?’ scenario is now reality.

In its procurement statement, NASA said its intention is to issue a sole source contract to ULA, meaning it’s the only upper stage being considered for this new iteration of the SLS rocket. An eight-page supporting document from NASA’s Marshall Space Flight Center (MSFC) in Huntsville, Alabama, was published to document the reasoning for its decision.

Among the stated reasons are the decades-long heritage of the RL10 engine, which has matured over time; the ability of the Centaur 5 to use the interfaces available on the Mobile Launcher 1 (ML1) along with the propulsion commodities of liquid oxygen and liquid hydrogen; and the experience of ULA’s teams working with NASA’s Exploration Ground Systems (EGS) at the Kennedy Space Center and elsewhere in the country.

They also noted that with the Centaur 3 upper stage achieving certification to launch humans as part of the Commercial Crew Program, there are a lot of common features with the Centaur 5.

“This approach leverages current support infrastructure and will use, with relatively minor modifications, an existing ULA upper stage,” NASA said. “All other alternative solutions fail to meet the performance requirements, would require significant modifications to hardware that is still under-development, or would require the development of new hardware that does not currently exist.”

NASA also said a time constraint to this decision caused them to select ULA as its sole choice.

“The NASA Kennedy Space Center (KSC) need date for processing is projected to be nine months prior to a launch,” NASA said. “Award to another source would cause unacceptable delays to current launch schedules.

“These delays would derive from the procurement process, on/off ramping of new contractor personnel, the potential need for reworked activities, as well as efforts necessary to satisfy SLS technical and programmatic drivers.”

The other upper stage that may have been in contention was from Blue Origin’s New Glenn rocket. Besides not having the previously stated advantages from NASA’s perspective, the agency also expressed concerns with the modifications needed to adopt Glenn Stage 2 for the ML1.

“Using the NGUS would require significant modifications to both the stage and the EGS infrastructure. For example, using NGUS would require relocating the Mobile Launcher Crew Access Arm and modification to the upper stage umbilical retraction mechanism,” NASA said.

“The stage could be shortened to meet VAB height constraints but would require full scale development and testing to qualify the stage for the shorter configuration. Full scale testing/requalification would result in unacceptable schedule impacts and additional cost risk to the SLS Program.”

What happened to the Exploration Upper Stage?

The original plan to use an EUS-enabled rocket would’ve enabled what NASA called “more ambitious missions” to the Moon, given that it would allow for the delivery of up to 11 metric tons more mass to the lunar surface under the Block 1B configuration as compared to the ICPS-powered Block 1 rocket.

However, a 2024 report from NASA’s Office of Inspector General found that, despite the SLS Block 1B being in development since 2014 and moving the first flight from Artemis 3 to Artemis 4, it continued to be behind schedule due in part to what the OIG called “quality control issues” at the Michoud Assembly Facility (MAF) in Louisiana.

“We project SLS Block 1B costs will reach approximately $5.7 billion before the system is scheduled to launch in 2028,” the report stated. “This is $700 million more than NASA’s 2023 Agency Baseline Commitment, which established a cost and schedule baseline at nearly $5 billion.

“EUS development accounts for more than half of this cost, which we estimate will increase from an initial cost of $962 million in 2017 to nearly $2.8 billion through 2028.”

The mid-2024 report also noted that at the time, delivery of the EUS to NASA was “delayed from February 2021 to April 2027.” That put the Artemis 4 flight, then projected for September 2028, to become further delayed.

Back in late September 2025, Spaceflight Now spoke with Sharon Cobb, the Associate Program manager for SLS at Boeing, about the Artemis 2 mission as well as the progress on the EUS.

“We’ve been working very diligently on Exploration Upper Stage. I was just at MAF last week and was able to see the liquid oxygen tank has been welded and tested,” Cobb said. “We’ve also got barrels in work there that are about to be welded for the flight unit. The LOX tank is a structural test article. So, we’re making really good progress on developing that Exploration Upper Stage.

Like with the core stage that launched the Artemis 1 mission, the plan was to perform what’s called a ‘green run’ with the EUS at NASA’s Stennis Space Center in Mississippi. That would include a full fueling of the upper stage and a full duration static fire test of the four RL10 engines as well.

Presumably, with this new direction for the SLS rocket, that will no longer take place, though NASA hasn’t specifically commented on what will happen with the EUS hardware currently in flow.

-----
My take:

This is the second of 3 postings regarding Isaacman’s major shakeups at NASA

GW
-----

#24 Re: Human missions » Why Artemis is “better” than Apollo. » 2026-03-09 09:08:58

From AIAA “Daily Launch” email newsletter 3-9-2026,  following the link to a Space.com article:

NASA wants to accelerate its Artemis missions to the moon. It will need to drop some big hardware to do it.
By Josh Dinner published 3 days ago

Some major projects might be left half complete after this latest shakeup.

NASA Administrator Jared Isaacman recently announced a significant restructuring of the Artemis program, and how the agency intends to return astronauts to the moon.

The new plan shortens the time between missions and redraws the map of which launches will achieve various program milestones. Nothing will change for Artemis 2, which may lift off in a matter of weeks, carrying four astronauts on a 10-day flight around the moon and back to Earth. Every mission after Artemis 2, however, has been adjusted.


The programmatic shuffle is rendering parts of the old Artemis plan obsolete, leaving major ground hardware half-built and an uncertain future for the Gateway moon-orbiting space station under development.

Isaacman announced the changes during a press conference on Feb. 27, citing unacceptable wait times between missions for Artemis' Space Launch System (SLS) rocket and an increased risk of relying on unproven technologies to carry out mission-critical objectives like landing astronauts safely on the lunar surface.


The Artemis 2 SLS is currently undergoing repairs in the Vehicle Assembly Building (VAB) at NASA's Kennedy Space Center in Florida, with a potential rollback to its launch pad in time for a launch window that opens April 1. Artemis 2 will bethe first crewed flight of the Orion spacecraft and the first return of astronauts to lunar space in more than half a century. Under the previous framework, it was meant to be followed by Artemis 3 in 2028, which would carry out the program's first moon landing with astronauts aboard SpaceX's Starship vehicle.


For Artemis 4, NASA planned to upgrade to the SLS Block 1B, which features a design powerful enough to launch elements of the Gateway space station intended for lunar orbit. Beginning with Artemis 4, NASA aimed to use the Gateway outpost around the moon for deep-space science and as an orbital layover stop where Orion and the program's lunar lander could dock to transfer crews headed down to the surface. Gateway, however, is nowhere to be found in any of NASA's recent Artemis updates.


Under NASA's new plan, there will be no SLS Block 1B. In the hope of shortening launch cadences from the current 3.5-year interval to the desired 10 months, SLS is being standardized into a single configuration. Instead of relying on SLS' current Interim Cryogenic Propulsion upper stage, NASA is reportedly considering converting United Launch Alliance's Centaur V upper stage for use on SLS for all Artemis launches after Artemis 3.

The revised Artemis program is now targeting 2027 for the launch of Artemis 3, but instead of landing on the moon, the mission will fly to low Earth orbit for rendezvous and docking maneuvers with either or both of the Artemis program's contracted moon landers — SpaceX's Starship and Blue Origin's Blue Moon spacecraft — depending on their relative readiness for orbital missions.


NASA partnered with SpaceX for Starship to serve as the lander for Artemis 3 and 4 and contracted Blue Moon for Artemis 5. But the agency is now signaling that it's ready to fly Artemis 3 with whichever lander can be made safely available when launch time rolls around.


With Artemis 3 turned into a lunar landing stepping stone around Earth, Artemis 4 has been tapped as the program's first crewed landing on the moon, which NASA still hopes to accomplish in 2028, with a possible second moon landing that same year on Artemis 5.

It's a major reshaping of Artemis' original mission progression, but the plan has been purposed to maximize both crew safety and NASA's chances of success, according to Isaacman. The shakeup doesn't come without some sacrifice, though.

Gateway's fate remains undetermined under NASA's new plan. Many components of Gateway are already in various states of assembly, but there is now no rocket to launch some of them once they're ready and no missions yet assigned to rendezvous with the proposed outpost. Congress advanced a revised NASA authorization bill on Wednesday (March 4) that supports many of Isaacman's proposed changes to the Artemis program, but only requires he brief lawmakers on Gateway's status within a few months' of the bill's passing.


If Gateway is on the chopping block, as seems likely, there is potential for its existing hardware to be repurposed for use in a possible base on the lunar surface, which has been a longstanding component of the Artemis program's goals and NASA's vision for a sustained human presence on the moon. One of the revisions in the authorization bill even grants the NASA administrator the freedom to "repurpose, reprogram, reconfigure, or reassign existing programs, platforms, modules, or hardware originally developed for other programs" in order to ensure that the space agency's Artemis goals are successful.

-----
My take:

This is the first of 3 postings regarding Isaacman’s major shakeups at NASA.

GW
-----

#25 Re: Human missions » International Space Station (ISS / Alpha) » 2026-03-07 18:57:30

The thing is wearing out. The Zvevda module cracks and leaks are only one example.  Sooner or later there will be a catastrophic failure in some module,  causing a fast depressurization,  and death of the crew.  The longer this thing's mission is extended,  the more likely such a fatal event is likely to occur.  Simple as that!

The problem here is NOT how long the ISS can fly,  it is that replacements for it have been delayed too long already.  Corporate business is OK with that delay,  greedy as they are;  the problem has been inadequate government setting of goals for that corporate business arena by letting appropriate contracts.  And that is mostly Congress's fault,  but substantially partly the administration's fault,  across multiple administrations.

GW
